Union Hill Road, Bridge over Route 9 Replacement Project Website
Virtual Public Information Center
April 23, 2025 – May 5, 2025
Public Information Center
The New Jersey Department of Transportation (NJDOT), committed to developing transportation improvements that best balance transportation needs, the environment, community concerns and costs, is holding a Virtual Public Information Center (PIC) to provide local residents, public officials, and the business community with information on the Union Hill Road, Bridge over Route 9 replacement project. You are encouraged to actively participate by providing comments by mail, e-mail, or the form below.
The Meeting
This PIC is being held virtually. Please visit this website any time between April 23, 2025 – May 05, 2025, to learn more about the project and leave comments. You have the opportunity to review a presentation and exhibits of the relevant items, submit questions, and leave feedback. Property owners with rental units are advised that tenants are also invited and encouraged to participate.
Submit a Comment
Project Information
Background
The purpose of this project is to replace the Union Hill Road Bridge over Route 9 due to its structural condition, insufficient vertical clearance over Route 9, inadequate deck geometry, and non-compliance with ADA standards for existing sidewalks.

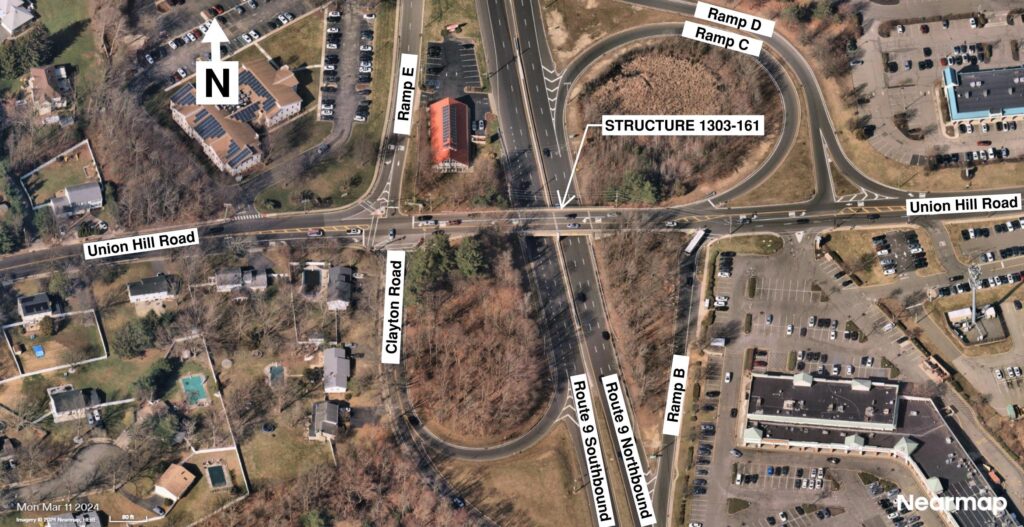

The two-span bridge is located on Union Hill Road at Mile Post 1.54 in Marlboro, Monmouth County. The bridge has one travel lane in each direction, a westbound left turn lane leading to the Clayton Road/Route 9 southbound on-ramp, and a sidewalk on the south side.
The Proposed Project
The Preliminary Preferred Alternative for the project includes the following key elements:
Traffic Construction Impacts
Traffic on Union Hill Road will be rerouted within the interchange using temporary ramps and two temporary traffic signals on Route 9. A pedestrian sidewalk will be maintained throughout construction. By using Accelerated Bridge Construction (ABC) techniques, the anticipated detour duration is six months.
Project Schedule
Preliminary Engineering 39_8fd0fd-93> |
Fall 2025 39_93e91c-29> |
Final Design 39_ccf6f1-ea> |
Fall 2025 to Fall 2028 39_caed97-13> |
Construction 39_3e6f11-3a> |
Fall 2028 to Fall 2029 Construction is expected to begin in Fall of 2028 39_633b73-f7> |
